Tunnel car wash system Q9.

A 9-brush tunnel
on one continuous wash line.

Conveyor washing for cars, SUVs and MPVs. Plan a Q9 tunnel around your vehicle flow, available space and wash program.

Published capacity: up to 60 cars per hour.
Actual flow depends on configuration and vehicle spacing.

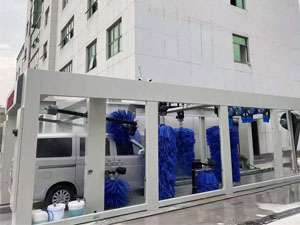

SHINEWASH Q9 tunnel washing a passenger vehicle on its conveyor
Q9 conveyor washing and air drying

See Q9
in operation.

Watch the conveyor, brush washing and drying stages in the original Q9 product video.

Q9 operation footage from the SHINEWASH product page. Your machine's appearance and wash sequence follow the configuration you order.

SHINEWASH Q9 tunnel car wash machine installed at an outdoor wash site
12.5 m equipment length

Nine brushes
working together.

Q9 combines top, vertical and lower-body brushes in one conveyor system.

Top brush
1
Vertical brushes
4
Skirt brushes
4

Need dedicated wheel brushes? Compare Q11 before choosing your configuration.

From prewash
to air drying.

A conveyor connects each stage.

  1. Prewash

    Water loosens surface dirt.

  2. Foam

    Detergent prepares the vehicle for brushing.

  3. Brush wash

    9 brushes clean the vehicle surfaces.

  4. Rinse

    Water rinses away detergent.

  5. Water wax

    Wax is applied in the configured program.

  6. Air dry

    Fans remove remaining surface water.

Look inside
the wash system.

Brush material, conveyor guidance and drying hardware work together through the wash sequence.

EVA cleaning brush material

EVA soft brushes

Soft brush material for contact washing. Routine inspection and cleaning belong in your operating plan.

Conveyor wheel guidance rails

Conveyor guidance

Wheel guidance aligns vehicles with the conveyor. Plan the approach, entry instructions and vehicle spacing.

Tunnel air drying fan assembly

Fan drying

Air-drying hardware follows the washing stages. The fan configuration sets the electrical load.

Equipment size
and site planning.

The installation reference is larger than the machine itself. Allow additional space for traffic and service access.

Q9 technical specifications
ModelQ9 conveyor tunnel
Brush configuration9: 1 top, 4 vertical, 4 skirt
Published wash speedUp to 60 cars / hour
Wash cycle reference1.5–3 minutes per car
Equipment dimensions (L × W × H)12.5 × 4 × 3 m
Installation reference (L × W × H)24 × 4.5 × 3.2 m
Maximum vehicle sizeLength unlimited; up to 2.3 m wide and 2.1 m high
Vehicle typesSedans, SUVs & MPVs within clearance limits
Wheel brushesNot included in the published Q9 configuration
Water use reference80–150 L per car; program dependent
Foam use7 mL per car
Water wax use12 mL per car
Electricity use reference0.6 kWh per car
Drying motors6 groups, 45 kW
Electrical supply380 V / 50 Hz, 21 kW
Key components
Vehicle sensingDense photoelectric sensors measure each vehicle and adjust the wash in real time
Operator stationWeatherproof stand with a 14-inch touchscreen; card, coin and app payment
PLC controlSiemens (Germany), stable with a low failure rate
BrushesEVA soft brushes with self-cleaning; they keep their shape and are gentle on paint
Fan dryingDrying power adjusts to the vehicle; drying rate over 95%; turbine fans with over 60% less noise
Motor reducersSITI (Italy), fully enclosed, IP68 waterproof, service life over 20 years
Vehicle guidanceFull-plate guidance with automatic left and right adjustment; widened galvanized track for wider wheels
Foam & waxPaint-safe foam detergent and hydrophobic shine wax; the shine lasts more than 3 days
Position sensorsPepperl+Fuchs (Germany), IP69K waterproof; measure vehicle travel and position
Pipes & nozzlesStainless steel

Published reference specifications. Final dimensions, utilities and configuration are fixed in the project drawings and quotation.

Before you
choose Q9.

Answers about clearance, wash capacity and installation.

What is the Q9 tunnel car wash system?

Q9 is a conveyor wash machine with 9 cleaning brushes. It moves passenger vehicles through washing and air-drying stages instead of washing one parked vehicle with a moving gantry.

How much space is required for Q9?

The equipment measures 12.5 × 4 × 3 m. The published installation reference is 24 × 4.5 × 3.2 m. Your complete site also needs approach, waiting, exit and service areas.

Does Q9 include wheel-cleaning brushes?

The published Q9 configuration has 1 top brush, 4 vertical brushes and 4 skirt brushes, with no dedicated horizontal wheel brushes. Compare Q11 if wheel-brush cleaning is part of your requirements.

Can Q9 wash SUVs and MPVs?

Sedans, SUVs and MPVs are listed for Q9, subject to a maximum vehicle width of 2.3 m and height of 2.1 m. Supply your largest vehicle dimensions and any roof equipment so the team can check clearance.

Does up to 60 cars per hour mean a 1-minute wash?

Throughput describes the line’s hourly vehicle flow, not the time each vehicle spends inside the tunnel. Wash stages, vehicle spacing and the selected program affect the actual operating rate.

What should I send for a Q9 quotation?

Include the installation country, usable site dimensions, vehicle range, expected wash volume and available utilities. The quotation then covers configuration, electrical demand, delivery, installation, training and after-sales support.
